16.         Officers' reports:

16.2     CEO Organisational Performance Report for January 2024.. 3

16.3     Citywide FOGO Kerbside Collection Service Update........... 31

Council

Meeting Agenda

15 February

2024

Doc ID No: A9834597

This matter has been determined to be of a significant nature and approval has been given to refer this report to the Council as a supplementary item.

ITEM:            16.2

SUBJECT:      CEO Organisational Performance Report for January 2024

AUTHOR:      Chief Executive Officer

DATE:           1 February 2024

Executive Summary

This is a monthly report by the Chief Executive Officer focusing on a summary of organisational performance in the areas of workplace health and safety, progress in the delivery of Council’s Corporate and Operational Plans, our people and culture, financial management, capital program delivery, flood recovery, external funding, significant risks and legal matters.  This report is for the month of January 2024. The report for this period highlights current significant matters and progress on key performance indicators.

RECOMMENDATION

That the Chief Executive Officer Organisational Performance Report for the month of January 2024 be received and the contents noted.

BACKGROUND

1.      Current Significant Matters

Ipswich Plan 2024 proceeds to final review
Following many months of work and engagement with the community Council resolution was achieved in January 2024 to send the revised draft Ipswich Plan 2024 for final State Government review and approval. The proposed new planning scheme, including the adopted changes made following community consultation, has been forwarded to the Minister for Housing, Local Government and Planning for final review.

Large Item Kerbside Collection
Ipswich City Council and Ipswich Waste Services have partnered with the Handel Group to provide our On-Demand Large Item Kerbside Collection service. FLEXiSKiP is a heavy duty,
2 cubic metre skip bag, big enough to fit mattresses, washing machines, bikes and other large items.

Ipswich waste directive review complete

A review of Ipswich City Council’s flagship Waste and Circular Economy Transformation Policy Directive has found significant progress has been made since its inception in 2020 and proposes new actions to continue to fight odour issues being faced by the Ipswich community.

2.      Workplace Health and Safety

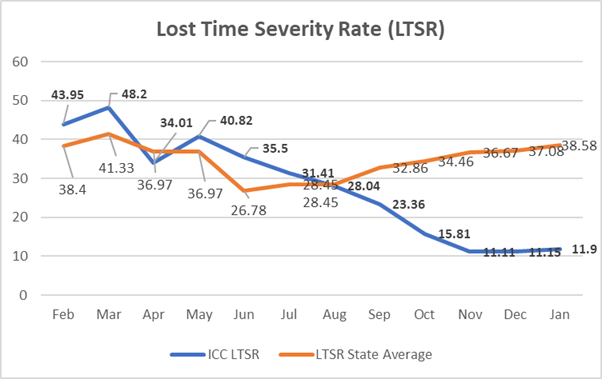

The LTIFR rate equates to lost time injuries every six months. The State Average is the average of LTIFR across the 62 local councils within the Local Government Association

Queensland (LGAQ) scheme. The Ipswich City Council (ICC) rate is significantly less than the State average.

The physical and psycho-social safety and wellbeing of the workforce continues to be the CEO and the organisation’s first and foremost priority.

The LTSR rate equates to the number of days lost for each LTI.  The State Average is the average of LTSR across the 62 local councils within the LGAQ scheme.

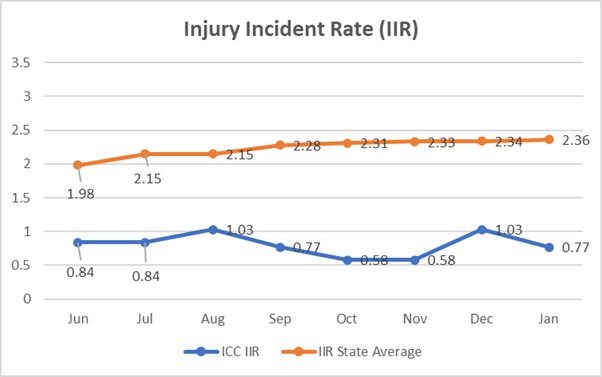

The Injury Incident Rate (IIR) is a new reporting indicator for Council as of June 2023. The IIR rate is the number of injury incidents per 100 workers.  The State Average is the average of IIR across the 62 local councils within the LGAQ scheme.

3.      Update on Corporate/Operational Plans

The Quarterly Performance Report for October - December 2023 (Quarter 2 period) on the 2023-2024 Operational Plan will be presented to the 15 February 2024 Council meeting.

The Annual Plan and the last quarterly report are available on council’s website:

https://www.ipswich.qld.gov.au/about_council/media/corporate_publications/annual-plan

4.      Major Key Performance Indicators

People and Culture

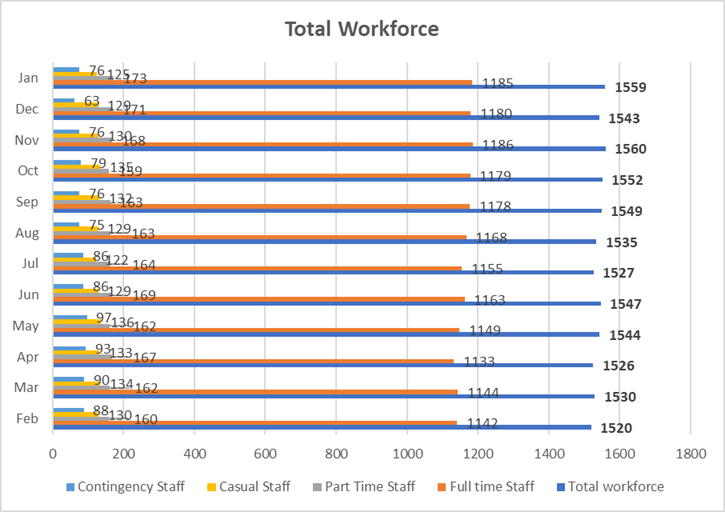

The total workforce for the council organisation was 1559 ‘head count’ as at January 2024.

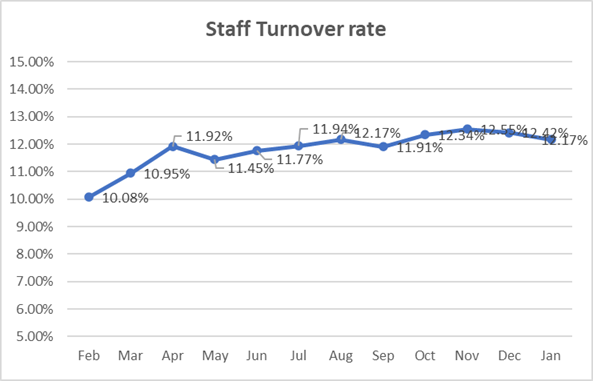

Staff turnover rate was at 12.17% in the month of January 2024, slightly lower than last month.

Finance

Due to the earlier timing of the February 2024 council meeting and the continued transition to Oracle Fusion, the financial results for January 2024 will be presented at the next Council Ordinary meeting.

Capital Delivery Program 2023-2024

The month of January resulted in a quieter than forecast month, and this was due predominantly to the significant rain experienced across the LGA. While no projects were significantly affected by the rain, crews were not able to complete productivity objectives, resulting in the delay in works.

The delays experienced are not expected to have any detrimental effect of the full financial year result.

5.      Risk and Compliance Update

Corporate Risk Register

Council’s corporate risk register is reviewed every two months at the Executive Leadership Team (ELT) Risk Committee meeting, Council’s corporate risk register will be reviewed at the ELT Risk Committee meeting held on 13 February 2024, with amendments agreed to, areas of responsibility, key mitigations, action plans and milestone progress.

Council’s corporate risk register and risk trends in these risks are reported through Council’s Audit and Risk Management Committee (ARMC) which is held every quarter.  The corporate risk register and risk trends in these risks are also circulated to all Councillors on a quarterly basis.

Council continues to seek to actively manage and mitigate its corporate risks.

Legal Matters

An overview of all current active court proceedings and all significant legal matters that are not the subject of court proceedings is provided in a confidential attachment to this report.

Matters that are not the subject of court proceedings will be considered significant where:

•       they concern subject matter of significant public interest/concern; and/or

•       where their outcome may present significant financial value/impact for Council; and/or

•       where their outcome may set an important precedent for Council.

Generally significant non-court matters will only be reported where they are the subject of dispute and management of that dispute is being administered by Legal Services (as opposed to where Legal Services’ involvement is ad-hoc or limited to the provision of internal advice), or where they concern a significant project for Council. The detail reported in respect of each matter listed has been provided with privacy, confidentiality, and legal professional privilege (and the requirement to maintain same) in mind.

6.      Current Consultation Matters

The following community engagement projects are included on Shape your Ipswich (SYI), the digital engagement platform that uses a range of techniques to connect with the community and promote consultation events https://shapeyouripswich.com.au/

The community engagement report prepared at the end of each consultation will include complete engagement information, including from non-SYI sources such as pop-up clinics.

Description of metrics used:

·    Contributors – the unique number of visitors who have left feedback or contributions - a contributor who makes more than one contribution is only counted once.

·    Visitors – a single visitor may make more than one visit to the site, but is only counted once.  IP addresses are used to determine unique Visitors.

Engagement projects open on Shape Your Ipswich (January 2024):

Project Name

Project Lead (Council Department)

Purpose of engagement

Aboriginal and Torres Strait Islander Community Engagement Guide

Environment and Sustainability Department and

Asset and Infrastructure Services Department

Consultation on the draft Aboriginal and Torres Strait Islander Community Engagement Guide. Project opened on 12 December 2023 – for Native Title Party and opened for general public on 18 December 2023

SYI statistics as at 31 January 2024:

·    21 SYI contributors

·    392 SYI visitors

Ripley Road and Fischer Road Upgrade

Asset and Infrastructure Services Department

Focused on sharing information with the community with the opportunity for feedback on the proposed upgrade of Ripley Road and Fischer Road changes. Project opened on 23 January 2024.

SYI statistics as at 31 January 2024:

·    8 SYI contributors

·    509 SYI visitors

Ipswich Youth Advisory Committee (IYAC)

Community, Cultural and Economic Development Department

The communications and engagement ‘hub’ for IYAC members.  This page is continually updated with updates on projects that IYAC members can been involved in. Project opened on 22 January 2024.

SYI statistics as at 31 January 2024:

·    0 SYI contributors

·    13 SYI visitors

Heart Check: the facts about the Nicholas Street Precinct development

(Information page)

Community, Cultural and Economic Development Department

Informing the community on the history and current state of the Nicholas Street Precinct development. Project opened on 24 November 2023.

SYI statistics as at 31 January 2024:

·    0 SYI contributors (information page only)

·    409 SYI visitors

Waste Odours in Ipswich

(Information page)

Environment and Sustainability Department and

Planning and Regulatory Services Department

Informing the community on waste odours impacting Ipswich residents. Project opened on 14 September 2023.

SYI statistics as at 31 January 2024:

·    0 SYI contributors (information page only)

·    680 SYI visitors

E-scooters in Ipswich

Asset and Infrastructure Services Department

Seeking feedback on the Beam e-scooter pilot scheme (2nd phase commenced 4 July 2023). Page has been updated to include extension to July 2024.  Project opened on 22 September 2020 and 2nd phase on 4 July 2023.

SYI statistics as at 31 January 2024:

·    30 SYI contributors (second phase)

·    396 SYI contributors (total project)

·    6,767 SYI visitors

Character Place Nomination

Planning and Regulatory Services Department

To seek nominations from the community on historical character places as part of the Planning Scheme. Project opened on 27 February 2023.

SYI statistics as at 31 January 2024:

·    5 SYI contributors (second phase)

·    435 SYI visitors

Creative Industries

(main page)

Community, Cultural and Economic Development Department

Engagement on creative industries programs under the Arts and Cultural Strategy. Main project page Creative Industries opened on 14 April 2023.

January 2024 subpages currently open and SYI statistics as at 31 January 2024:

·    ARTiculate – 9 Workshops opened for 2024 – subpage project opened 18 January 2024

All participants register through Humanitix

·    2024 Regional Arts Development Fund – subpage project opened 15 January 2024

All applications are made via Smarty Grants

·    Framing our city’s artistic legacy – subpage project 10 August 2023 for submit ideas question

0 SYI contributors for submit ideas

SYI statistics as at 31 January 2024 for Ipswich Central main page:

·    111 SYI contributors

·    10,011 SYI visitors

Ipswich Central

(main page)

Community, Cultural and Economic Development Department

Ipswich Central Revitalisation projects, communications, information sharing and public events. Main project page Ipswich Central opened on 28 November 2019.

January 2024 subpages currently open and SYI statistics as at 31 January 2024:

·    Developing the Cultural Heart – subpage project opened 4 December 2023 to 29 January 2024

49 SYI contributors

·    Light up Ipswich Central - subpage project opened 21 August 2023

2 SYI contributors

·    Creating Places for People not cars – subpage project opened 31 March 2023

35 SYI contributors

·    Out and About (event page) – subpage project opened 1 April 2022

5 SYI contributors (21 events submitted)

·    Green Walkable Streets – Have you seen the new scramble crossing? – subpage project opened 29 November 2022

1 SYI contributor

SYI statistics as at 31 January 2024 for Ipswich Central main page:

·    21,439 SYI visitors

Community Panel

Community, Cultural and Economic Development Department

Council’s community engagement program for future-focussed policy, strategy, projects and plans. Project opened 20 December 2021.

SYI statistics as at 31 January 2024:

·    189 SYI contributors

·    25,387 SYI visitors

Community Panel – closed member page

Community, Cultural and Economic Development Department

The communications and engagement ‘hub’ for the community panel. This page is continually updated with updates on projects the panel has been involved in. Project opened 20 December 2021)

SYI statistics as at 31 January 2024:

·    72 SYI contributors

·    372 SYI visitors

The Ipswich Heritage Network Group – closed member page

Planning and Regulatory Services Department

Closed page for information sharing and discussion on our city’s heritage, history and conservation. Project opened 29 July 2022.

SYI statistics as at 31 January 2024:

·    6 SYI contributors

·    22 SYI visitors

Habitat Gardens Partnership – closed member page

Environment and Sustainability Department

Platform for urban property owners to share their thoughts, ideas, successes, learnings and conservation aspirations. Project opened 11 November 2019.

SYI statistics as at 31 January 2024:

·    4 SYI contributors

·    17 SYI visitors

Engagement projects (new) that may open in the month of February 2024:

Project Name

Project Lead (Council Department)

Purpose of engagement

Critical and Enabling Infrastructure

Community, Cultural and Economic Development Department

(Information only page)

Information on the funding of the 3 major roads in Ipswich.

Engagement project updates January 2024 – closing the loop:

Project Name

Project Lead (Council Department)

Purpose of engagement

Ipswich Central

(main page)

Community, Cultural and Economic Development Department

Developing Cultural Heart engagement subpage opened on 4 December 2023 and closed 29 January 2024

SYI statistics as at 31 January 2024:

·    49 SYI contributors for Cultural Heart subpage

·    21,439 SYI visitors for Ipswich Central main page

Indigenous Soldiers Remembrance and Healing Project

(main page)

Asset and Infrastructure Services Department

Queens Park Ceremonial, Healing and Remembrance Place engagement subpage opened on 26 May 2023 and closed 10 June 2023.

Project updated on 15 January 2024:

·    Engagement feedback shared

·    Release of concept design

SYI statistics as at 31 January 2024:

·    18 SYI contributors

·    478 SYI visitors for Indigenous Soldiers Remembrance and Healing Project

(main page)

Resource Recovery Infrastructure

Environment and Sustainability Department and

Planning and Regulatory Services Department

Project updated on 22 January 2024:

·    Riverview Recycling and Refuse Centre upgrades changes and schedule.

SYI statistics as at 31 January 2024:

·    32 SYI contributors

·    384 SYI visitors

Limestone Park – What is happening?

Asset and Infrastructure Services Department

Project updated on 19 January 2024:

·    Engagement feedback shared to community

SYI statistics as at 31 January 2024:

·    216 SYI contributors

·    990 SYI visitors

Richardson Park Upgrade

Asset and Infrastructure Services Department

Project updated on 18 January 2024:

·    Project funding received

SYI statistics as at 31 January 2024:

·    31 SYI contributors

·    898 SYI visitors

Cameron Park Upgrade

Asset and Infrastructure Services Department

Project updated on 18 January 2024:

·    Project funding received

SYI statistics as at 31 January 2024:

·    130 SYI contributors

·    1,814 SYI visitors

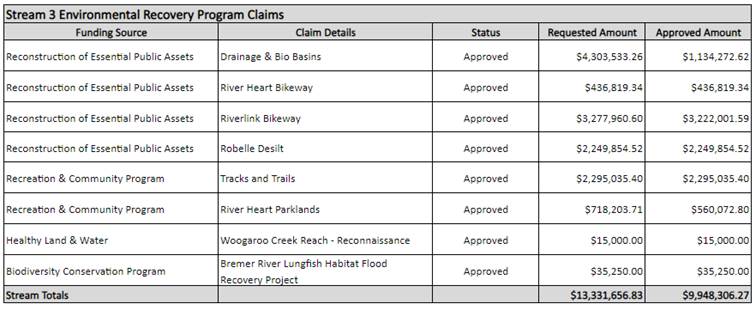

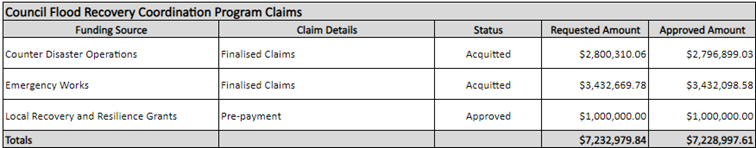

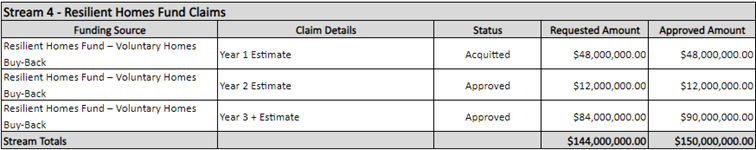

7.      External Funding

Council utilises grant funding from various external sources, primarily Federal and State Government, to assist with the delivery of many projects and services across the organisation.  These include operational programs from community development, libraries and sports, through to capital funding to assist with infrastructure projects delivery.

Council can also utilise grant funding to partner with external organisations building partnerships where the project outcomes align with Council's strategic goals.

The below information summarises information related to:

·    external funding revenue received by Council;

·    any funding decisions received during the month of January 2024

·    applications that have been submitted and are awaiting a decision;

·    applications being prepared for submission to a funding body; and

·    the grant opportunities suitable for local governments to apply.

Council’s External Funding Team works closely with our Capital Program Delivery Branch and other key stakeholders within council to identify opportunities and the management of successful applications between council and the funding body.

Grant Revenue as at 31 January 2024

Funding Type

Total number of Grant projects

Total External Funding Received

Total Cost of Grant funded project/s (inc. Council & other Contributions)

State Government

49

$21,284,763

               $39,989,278

Federal Government

17

$16,134,784

$28,034,095

Other

4

$571,924

$1,553,349

Total

70

$37,991,471

$69,576,722

Grant Decisions received in January 2024

Grant Program

Successful/

Unsuccessful

Total Grant Funding

Total Project

School Transport Infrastructure Program (STIP)- Department of Transport and Main Roads

Westside Christian College – Bellevue Rd Footpath

$189,000

$378,000

School Transport Infrastructure Program (STIP) - Department of Transport and Main Roads

Redbank Plains State School – Wandera Ct Footpath

$59,400

$119,000

Grant Applications submitted and awaiting outcome

Grant Program / Funding Body

Requested Grant Amount

Total Est. Project Cost

Project Submitted in Application

Minor Infrastructure and Inclusive Facilities Fund – Round 2

$178,227

$222,784

Tivoli Lighting

Minor Infrastructure and Inclusive Facilities Fund – Round 2

$84,995

$106,243

Kippen Park Lighting

SEQ Liveability Fund - EOI

$7,272,000

$9,272,000

Tivoli Sports Complex Sports Facilities Development

SEQ Liveability Fund - EOI

$7,272,000

$9,272,000

Redbank Plains Recreation Reserve Sports Facilities Development

Bridges Renewal Program

$500,000

$8,185,876

Purga School Road Bridge

Heavy Vehicle Safety and Productivity Program

$3,904,203

$4,880,254

Purga School Road

Queensland Risk and Resilience Reduction Fund (QRRRF)

$100,000

$100,000

LDCC Scoping and Capability Enhancement

Queensland Risk and Resilience Reduction Fund (QRRRF)

$300,000

$300,000

Community Resilience

Unsubmitted Applications Currently in Progress

These applications have been internally identified and endorsed that are currently in development as at end of January 2023, pending submission. Requested funding and total project costs will be advised in future reports.

Grant Program

Proposed Project

Application/schedule due

SEQ Liveability Fund – Detailed Application

Tivoli Sports Complex Sports Facilities Development

12 April 2024

SEQ Liveability Fund – Detailed Application

Redbank Plains Recreation Reserve Sports Facilities Development

12 April 2024

Active Women and Girls

Fit and Fierce Program

6 March 2024

Grant Opportunities Communicated to the Organisation

The programs are communicated to council by the funding body or identified by council’s External Funding team. This information is shared across stakeholders in council for consideration.

Grant Program

Funding Entity

(Fed/State/Other)

Total grant pool*

Closing Date

Celebrating Reconciliation Grant

Queensland Government

Not Available

22 January 2024

Community Energy Upgrades Fund

Department of Industry, Science and Resources

$100 Million (over two rounds)

30 April 2024

Saving Native Species Grants

Department of Climate Change, Energy, the Environment and Water

$20 Million

21 February 2024

Active Women and Girls Funding Program

Queensland Government

$15 Million

6 March 2024

Queensland Feral Pest Initiative

Queensland Government

$27 Million (Over 6 years)

29 February 2024

*The total grant pool is subject to the program guidelines, and council may only be eligible for some rounds or certain smaller pools of funding.

8.      Council Flood Recovery Coordination

Council is currently working with the Queensland Reconstruction Authority (QRA) and other Departments regarding the costs associated with the February and May 2022 flooding and significant rain events.

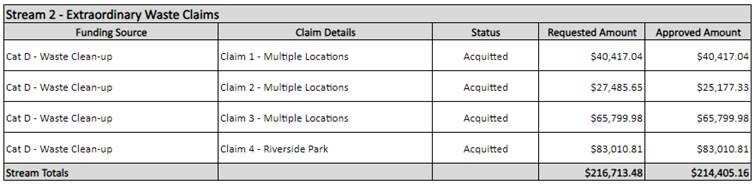

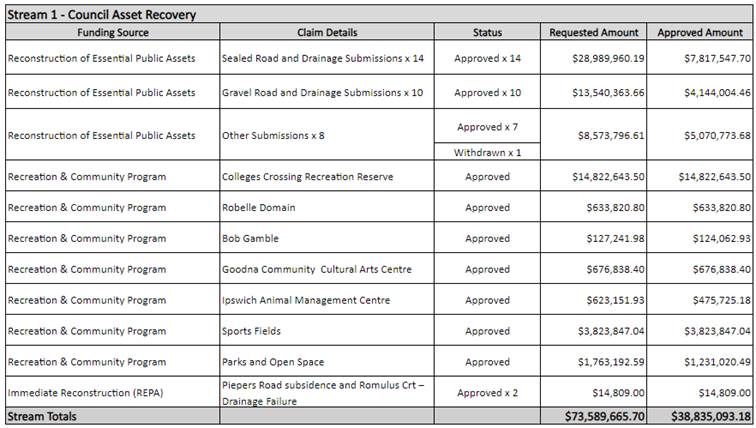

The following tables provide an overview of the current status of claims:

9.      Council Resolutions

Number of resolutions finalised since last report (18 January 2024): 29

Number of resolutions in progress as of 8 February 2024: 108

HUMAN RIGHTS IMPLICATIONS

HUMAN RIGHTS IMPACTS

RECEIVE AND NOTE REPORT

The recommendation states that the report be received and the contents noted. The decision to receive and note the report does not limit human rights. Therefore, the decision is compatible with human rights.

Attachments and Confidential Background Papers

1.

Action Report as at 8 February 2024

CONFIDENTIAL

2.

2024-01 Legal Services Confidential Attachment for CEO Organisation Performance Report for January 2024

Council

Meeting Agenda

15 February

2024

Item 16.2 / Attachment 1.

Council

Meeting Agenda

15 February

2024

Doc ID No: A9862490

This matter has been determined to be of a significant nature and approval has been given to refer this report to the Council as a supplementary item.

ITEM:            16.3

SUBJECT:      Citywide FOGO Kerbside Collection Service Update

AUTHOR:      Manager, Resource Recovery

DATE:           8 February 2024

Executive Summary

This is a report to provide Council with an update concerning the expansion of the core kerbside collection service to a 3-bin system, including a Food Organics Garden Organics (FOGO) bin as presented to Growth Infrastructure and Waste Committee on 11 May 2023, in relation to some significant external forces that have impacted on the projected timeline.

Recommendation/s

A.           That the expansion of the core kerbside waste collection service to include a Food Organic Garden Organic (FOGO) collection be delayed until the 2025-2026 financial year.

B.           That, subject to the commencement date of the Food Organics Garden Organics service, the Opt-In FOGO service continue with a prorated charge to be applied for all non-rated Opt-In (rental) Food Organics Garden Organics services provided prior to the commencement of the new service.

C.           That the budget implications of the revised commencement date be included in future Council budget submissions.

D.           That Council note the funding commitment now provided by the Qld State Government (refer confidential Attachment 1).

E.           That Council note a multi-stage communication, education and engagement program will be developed in the coming months.

RELATED PARTIES

There was no declaration of conflicts of interest.

ifuture Theme

Natural and Sustainable

Purpose of Report/Background

This report is to advise Council of the changes which have occurred within the Food Organic Garden Organic (FOGO) processing industry since the brief detailing the expansion of the core kerbside collection service to a 3-bin system was presented to Growth Infrastructure and Waste Committee on 11 May 2023.

Under the original program delivery strategy, Ipswich Waste Services (IWS) was seeking to commence the 3-bin core kerbside collection service in early 2024-2025 financial year.  The purchase of 68,000 FOGO bins and 6 trucks has already been contractually executed in this current financial year and the citywide kerbside bin lid colour harmonisation process has now been completed as of December 2023.  The bin harmonisation process was a considerable project which saw the replacement of more than 15,000 old dark green general waste bin lids with new Australian Standard red coloured lids across the entire Ipswich Local Government Area. From a FOGO material processing perspective IWS had planned to utilise the existing contractual arrangement which included extension provisions through to 2026, until a new long-term contract was in place thus permitting the service roll out to occur in early 2024-2025.

Issues

Since this plan was initially developed there has been considerable movement in areas outside the control of IWS relating to the processing of FOGO material, these changes have included:

§ Compliance Action by the Department of Environment, Science and Innovation (DESI), seeking a restraining order against Council’s processor from receiving and processing highly odorous materials (this technically includes FOGO material).

§ DESI has also commenced an Environmental Authority (EA) modernisation process whereby companies seeking to establish a FOGO processing facility will now need to comply with rigid licencing requirements (e.g. 1 part per billion Per-and Polyfluorinated Substances (PFAS) limits for any compost produced).

§ Council’s FOGO processor has lodged a challenge in the Planning and Environment Court relating to a decision made by Council in response to a Development Assessment amendment application they submitted to modify their operations at Swanbank.

§ Council has also commenced compliance action against its FOGO processor in regard to breaches of their existing Develop Application operation conditions.

All of these issues create uncertainty in the market and IWS believe it prudent to wait for these issues and clarity around long term processing to be further resolved before commencing the service expansion.

Presently to mitigate the impacts of these influences, IWS has undertaken a short-term FOGO processing procurement activity.  This market engagement will provide Council with the flexibility to not take up the contractual extension options under the existing arrangement, should it prove most advantageous to Council; or if the current contractor is legally restrained from receiving and processing FOGO material.  Tenders for this potential 2-year engagement closed on Monday 5 February, and Council is currently assessing those to determine if sufficient market capability currently exists to process the City’s FOGO material to a modernised EA condition standard.

Further IWS have been working closely with the Council of Mayors South-East Queensland Project Management Office (CoMSEQ PMO) and the Department of Environment, Science and Innovation (DESI) and have been successful in procuring $9.5M funding to assist Council to deliver on our City-Wide FOGO through their Grow FOGO program, that will assist with FOGO bins purchases, kitchen caddies, the previously noted bin lid harmonisation program and education and awareness programs.  In addition, in recognition of the challenges faced at the moment the funding also includes monies to:

“…collect organic materials and send them to a facility that meets the Queensland Government’s best practice guidelines for composting high odour risk materials, given there are currently no local operators that meet these standards.” (Refer details of funding in CONFIDENTIAL ATTACHMENT 1)

There are limitations on this funding, and this adds further prudence to Council deferring the transition to a core 3-bin kerbside waste collection service till the 2025-2026 financial year, when additional market processing capacity will become available.

The benefits of this strategy will enable Council to financially and logistically take a responsible step-change approach to implement this significant change.  This additional time can also further be utilised to rollout out extensive education programs to prepare the city for a FOGO service which is sensitive to contamination, and requires proactive behaviour change from the Ipswich community.

Legal IMPLICATIONS

This report and its recommendations are consistent with the following legislative provisions:

Local Government Act 2009

Waste Reduction and Recycling Act 2011

policy implications

Not applicable

RISK MANAGEMENT IMPLICATIONS

Significant reputational and financial costs could be borne by Council if the City is required to transport the expanded quantities of FOGO material (from a Citywide core service), potentially interstate in order to locate an approved processor of the material.  Delay of the planned expansion of the core kerbside waste collection service till 2025-2026 will mitigate this risk when more regional processing capability will be available.

Financial/RESOURCE IMPLICATIONS

The funding as recognised within Confidential Attachment 1 will be incorporated into the relevant future years’ council budget submissions. The expenditure items as presented to Growth Infrastructure and Waste Committee on 11 May 2023 will be reallocated into the relevant financial year in order to facility a rollout of the expanded kerbside collection service in the 2025-2026 financial year.

COMMUNITY and OTHER CONSULTATION

Community engagement undertaken to inform the development of the Resource Recovery Strategy found that almost 95 per cent of respondents supported a three-bin kerbside waste collection system.  This paper for noting, supports the delivery of this service in the most advantageous and responsible means possible given the above changes to processing conditions.

IWS have be working closely with DESI officers of local and state-wide FOGO education materials and programs, including some very significant engagement with the two dedicated FOGO trial areas, that has seen contamination reduce significantly to low single digit percentages.

Moving forward IWS will develop some initial communication to explain the revised timeline and then progress into an extensive communication, education and engagement program to best utilise the addition time the roll out delay provides.

Conclusion

In conclusion, when assessing the risks associated with progressing with the expansion of the core kerbside waste collection program to include a FOGO service, it is most prudent that the timing of this transition be amended to occur during the 2025-2026 financial year for the reasons detailed above.

HUMAN RIGHTS IMPLICATIONS

HUMAN RIGHTS IMPACTS

OTHER DECISION

(a)  What is the Act/Decision being made?

The purpose of this report is to seek to delay the expansion of the core kerbside waste collection service to include a Food Organics Garden Organics (FOGO) bin until 2025-2026 financial year.

(b) What human rights are affected?

No human rights are affected as this report does not affect the communities general waste collection service provided by Council.

(c)  How are the human rights limited?

Not applicable, Council is seeking to delay the introduction of a new core waste collection service.

(d) Is there a good reason for limiting the relevant rights? Is the limitation fair and reasonable?

Not applicable, Council is seeking to delay the introduction of a new core waste collection service.

(e)  Conclusion

The decision is consistent with human rights.

Attachments and Confidential Background Papers

CONFIDENTIAL

1.

GROW FOGO Funding Advice - 8 January 2024

David McAlister

Manager, Resource Recovery

I concur with the recommendations contained in this report.

Kaye Cavanagh

General Manager (Environment and Sustainability)

“Together, we proudly enhance the quality of life for our community”
